News, views and contacts from the global Railway industry

Docklands Light Railway Capacity Upgrading, United Kingdom

Key Data

Since opening in 1987, the Docklands Light Railway (DLR) has been central to the regeneration of east London. Now its significance is far greater than originally envisaged. The DLR started with three 'arms' linking termini at Stratford (north), Island Gardens (south) and Tower Gateway (west), the intersection being at Poplar.

It has been a key contributor to residential renewal and to the creation of the Docklands business and finance district centred on the Canary Wharf complex which doubled its workforce to 86,000 between 2001 and 2007. A role never foreseen was its forthcoming leading role as a key component in the UK's staging of the 2012 Olympic Games.

The project

The original 13km, 13-station system cost £77m, but in the following 20 years over £1bn was spent on upgrades and extensions. New lines extended to Bank (July 1991), Beckton (March 1994), under the Thames to Greenwich and Lewisham (November 1999) and as part of a project for a second Thames crossing, to London City Airport (December 2005) where by 2008 it was handling around 50% of arriving and departing air passengers. A new line connecting King George V to Woolwich Arsenal was laid by January 2009.

Expected to host 500,000 spectators daily, the majority at east London venues, the Olympic Games provided an opportunity to realign the area's rail services.

The DLR has taken over the now abandoned North London Line section between Stratford and Canning Town from Network Rail. This gives direct access to the Olympic Park.

"The original 13km, 13-station system cost £77m, but in the following 20 years over £1bn was spent on upgrades and extensions."

The DLR also serves ExCel London, Greenwich Park and the Woolwich Royal Artillery Barracks in 2012 during the Olympic and Paralympic Games.

In May 2006 Transport for London (TfL) awarded a new £400m franchise to operate and maintain the DLR system to Serco Docklands (part of the Serco Group), reflecting improvements made during the nine years of its previous franchise begun in 1997.

The new franchise brought targets, including at least 96% of trains running within three minutes of schedule, completion of the Woolwich Arsenal and Stratford International extensions, and the three-car upgrade to increase capacity between Bank and Lewisham, by early 2010. The platforms that were closed for upgrade for three-car operation were opened in February 2010. The new three-car trains will first run on the Bank-Lewisham branch as the platform extensions had already being carried out.

In January 2010, the feasibility study associated with the extension of the DLR to Kidbrooke, Woolwich Arsenal and to Eltham was commissioned by the Eltham Regeneration Agency.

Infrastructure

As of January 2010, the DLR has 40 stations along a 31km-long line. The system has five branches in all directions.

The branches are to Lewisham in the south, Stratford in the north, and to Beckton and Woolwich Arsenal in the east. The western branch is to Central London and is split to serve Bank and Tower Gateway.

Because of the territory it traverses, a mix including existing intensive land use and the large bodies of water that were former East London docks, much of the DLR is on viaduct, with many high-level stations. The original depot at Poplar, like the second at Beckton which has more available space, may be extended to handle more and longer trains.

In 2009, 70 million passenger journeys were recorded and 100 million are forecast for 2012. This was anticipated as a long-term trend and accordingly the programme for capacity increase was instituted. Platforms are being lengthened and elevated structures being reinforced to take trains increased from two to three units.

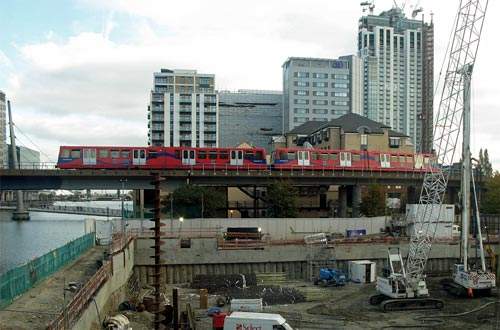

Wholesale extensions of viaducts and realignment of curves are taking place, with the key installations of North Quay Junction north of Canary Wharf and at Canning Town being remodelled. Lack of space due to adjacent curving track forced the reconstruction of South Quay station on a new, more easterly site. In May 2007, Taylor Woodrow was awarded a £200m contract for the construction works in connection with the train-lengthening project.

Commissioned in advance of the original system's opening, a 1.6km (1 mile) underground line was built to Bank in London's traditional financial centre. Now the DLR's busiest weekday station, the most westerly DLR terminus was constructed beneath the existing London Underground platforms.

The initial City terminus, the elevated Tower Gateway, was retained to handle Beckton Line trains and was closed until 2009 for rebuilding under the capacity increase programme. Stations on the Lewisham line, partly in a bored tunnel and a 1.7km cut and cover section at near ground level, were subject to substantial reconstruction.

"The £238m Canning Town-Stratford International line opened in September 2010."

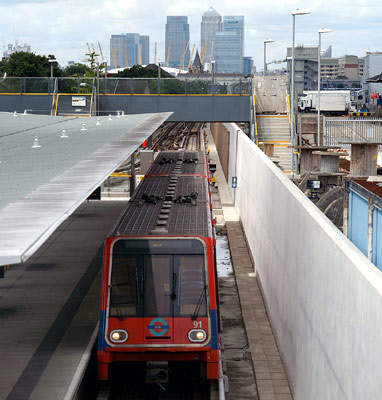

King George V in North Woolwich formed the temporary terminus of the branch from Canning Town opened in 2005 to serve London City Airport and, by early 2009, Woolwich Arsenal. Breakthrough on the second of the new twin-bore tunnels under the Thames was in July 2007.

The 1.8km Woolwich Line extension project that connects Woolwich on the south of the river with DLR King George V station was opened before the scheduled date in January 2009.

Like Lewisham, Woolwich DLR will be an interchange with mainline commuter trains, further reducing the need for travel via central London.

In July 2007, a £67m main construction contract was awarded to a Skanska-GrantRail joint venture for the £238m Canning Town-Stratford International line. The project includes rebuilding stations at Stratford, West Ham, Canning Town and Royal Victoria to DLR specification, notably for the step-free access that applies across the system. The line opened in September 2010.

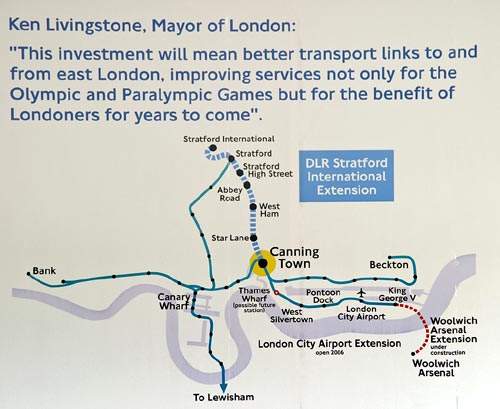

New stations will be built at Star Lane, Abbey Road, Stratford High Street and Stratford International, the last at the Olympic Park and providing connections with forthcoming high-speed North Kent-London St Pancras services. A new station to serve a residential area, Langdon Park on the original Stratford line, opened in 2008.

Rolling stock

Technologies such as monorails, guided buses and rubber-tyred trains were rejected in favour of conventional steel wheel on rail. Eleven trains of articulated two-car formation with wide internal gangway connection were ordered from Linke-Hoffman-Busch of Germany for the original DLR operation. These were joined by ten of a modified design assembled in the UK for use on the Bank extension.

With the P86 unsuitable for sections of the growing DLR and modifications required for use under the incoming Alcatel signalling also problematic for the P89, these first 21 trains were sold to Essener Verkehrs-AG. With fitment of driver cabs and pantograph they were deployed on EVAG's Stadtbahn.

Subsequently DLR services have been operated by several batches of type B90/B92/B2K vehicles built by BN Construction (later Bombardier) in Belgium. The first of the 94-strong fleet was delivered in 1991, the last entering service by 2003. Commonality in terms of passenger use has been assisted by refurbishments.

Indicative of system expansion and a sustained ridership increase, 55 trains with a new external appearance and jointly funded by Transport for London and the Olympic Delivery Authority were ordered between 2004 and 2006. Being built at Bombardier's Bautzen plant in Germany, electrical equipment is from the Mannheim factory and bogies from Siegen. The first was formally presented in March 2008 and 33 trains were delivered by October 2009. All vehicles were deliveried by the end by July 2010.

Signalling / communications

Automatic train control is managed from the central control room using a "moving block" system which allows for closer headways than a conventional fixed block system. Replacing the original GEC installation and required to facilitate capacity growth, it is based on the Seltrac system, developed by Alcatel of Canada.

The train's on-board computer continually communicates with the central computer, and if this signal is broken a train will be stopped until authorisation is given for it to continue. A train can still be driven manually, but if the driver over-speeds or leaves a station when the route is not set, emergency brakes will be automatically applied.

In the event of a complete signalling failure, trains can run in emergency mode at 20km/h (12mph). The system allows for full bi-directional operation if required. DLR remains the UK's only driverless automatically operated passenger railway.

In March 2010, Thales was contracted to provide SelTrac, a communications-based train control technology that accommodated the DLR's upgrade from two to three-car services.

As part of Transport for London, DLR is covered by the Oyster card payment system and Travelcards that cover multi-mode journeys, highly relevant with the system's multiple interchanges.

"DLR remains the UK's only driverless automatically operated passenger railway."

The future

During 2012, the line will be the principal link between games venues at the Olympic Park and the ExCel Arena that adjoins Custom House DLR station.

Government approval is being sought for a four-station Dagenham Dock extension that will connect at a new junction at Gallion's Reach. It is projected to begin construction in 2013 for operation by 2017.

The £180m Woolwich Line project remains on target for a February 2009 opening of the remaining 1.8km beyond King George V.

Growing complexity of the system and multiple destinations may call for routes to receive distinguishing designations as per TfL Underground. Given the runaway success of DLR, prospects for continuing expansion of the system appear good.

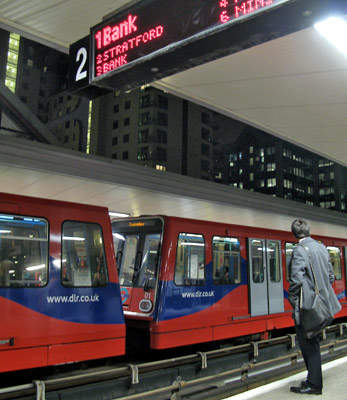

South Quay station is being relocated to accommodate the three-car/platform extension project.
West India Quay station was refurbished in a $1.85m project completed in October 2007.
With a new twin-bore Thames tunnel, the Woolwich extension opened before its planned date of Janury 2009.
King George V in North Woolwich formed the temporary terminus of the branch from Canning Town opened in 2005.
The DLR fleet has undergone internal refurbishment and external livery changes.
DLR maintains a high level of communications with its users.
Like London City Airport which it now serves, DLR has grown from low profile origins into being a key part of the capital's transport infrastructure.

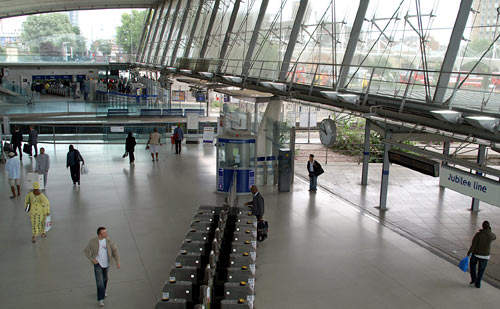

Low-level platforms seen here at Stratford Regional are being reworked for the Canning Town-Stratford International DLR extension.
An extension to the DLR was built between King George V and Woolwich Arsenal. Another extension is being built from Canning Town to Stratford International.
Platform extension and viaduct strengthening: West India Quay, 2008.
